Many residents have raised concerns that development was progressing on the Amlets Lane site prior to discharge of pre-commencement planning conditions regarding sewage.
In response to this, two Committee Members of Cranleigh Society visited the site of Amlets Park on 20th January and had a tour of the site and lengthy discussions with the Site Manager and Construction Director.
They confirmed the work they have done so far, as well as work currently being carried out, can be summarised as follows:
- The overhead electric cable which crosses the site has been diverted and located underground. This work was undertaken in December.
- Jointing works are taking place within the site in January 2017 – extreme weather could delay the work.
- Approved tree felling etc to the site frontage in relation to the proposed access (as agreed with WBC’s Tree Officer and in accordance with the approved plans) took place in December.

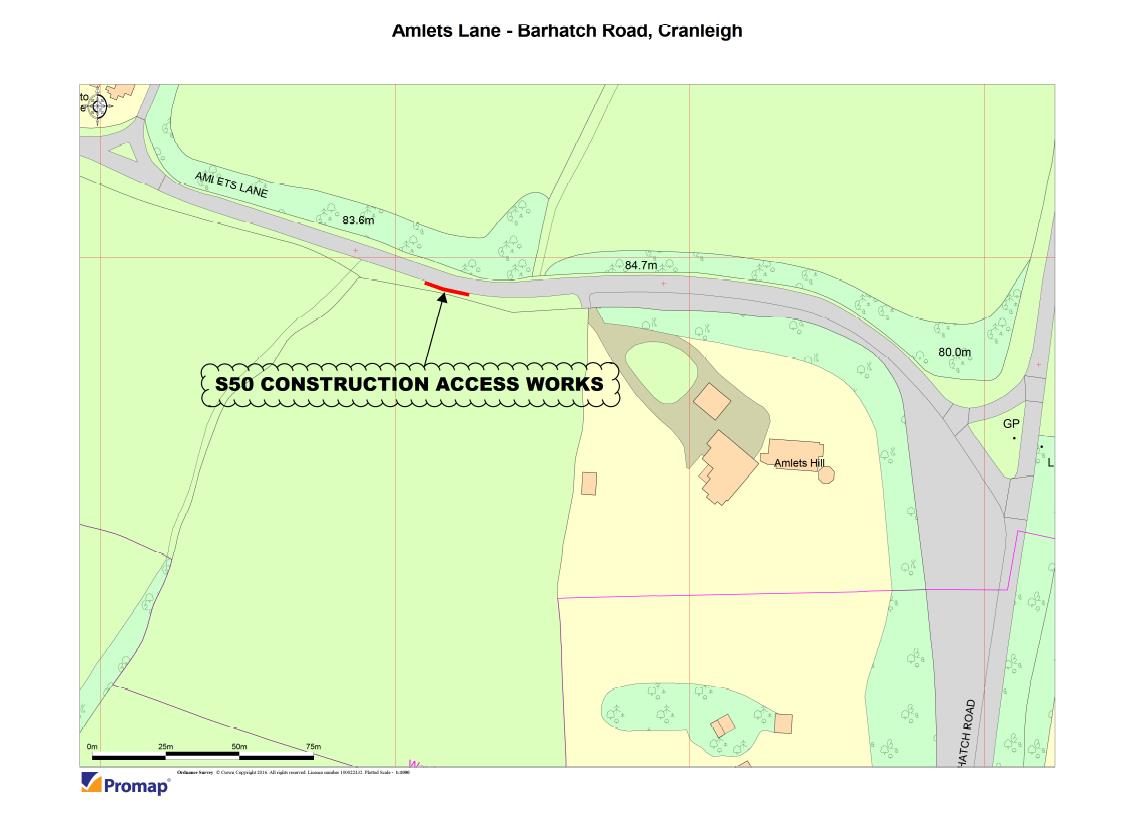

- In relation to the proposed access works they commenced operations in December. However in advance of the S278 works (legal agreement between local highway authority and developer to either pay for, or make alterations or improvements to, the highway) , interim works are due to be carried out over the extent of the area coloured brown on the plan below as well as works to form clear visibility splays explicitly for highway safety.
- A S50 licence application, for permission to carry out works to break into the public highway, was submitted to Surrey County Council, in accordance with the S50 Plan. A licence was issued and works have commenced.
- Temporary traffic lights are now in operation for the duration of the interim works.

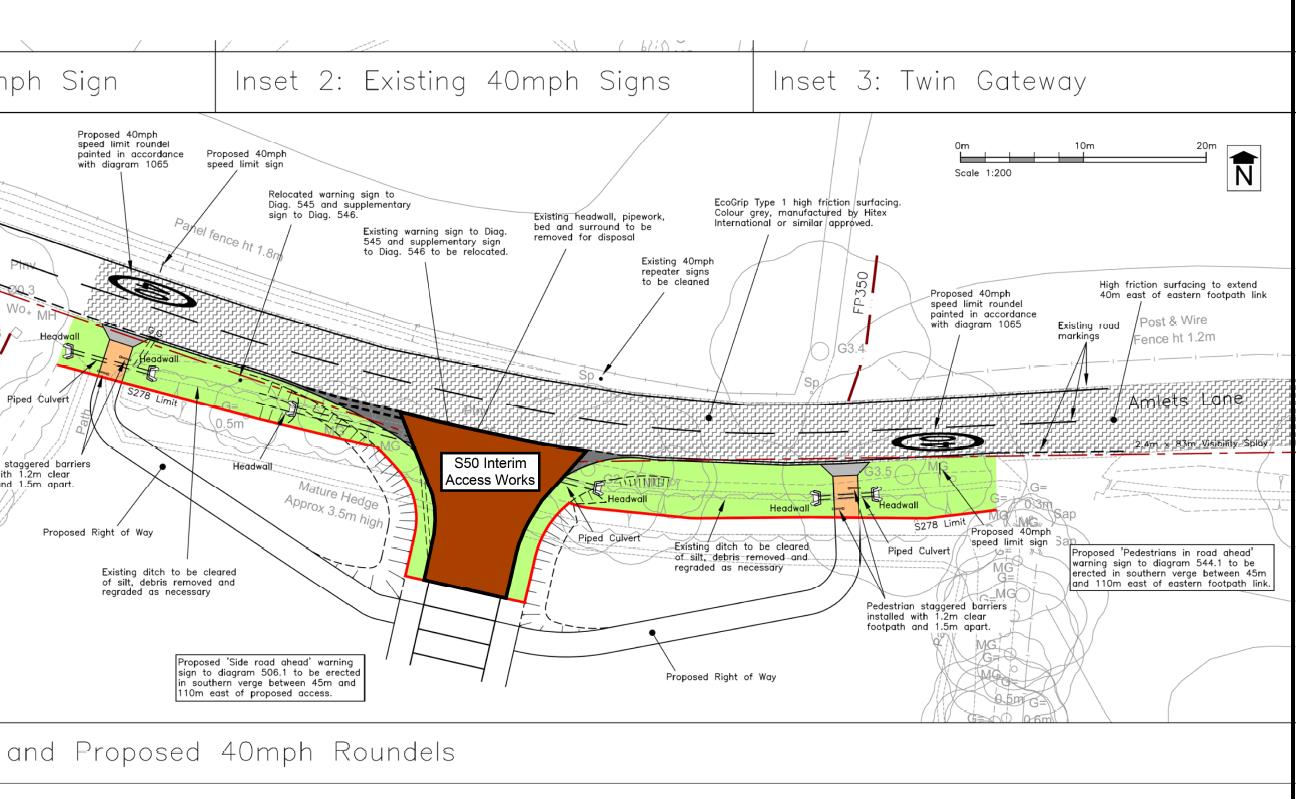

- The works include tree and hedge clearance, the laying of a culvert pipe, where the brown coloured access crosses the roadside ditch, the removal of soils to a suitable formation over the extent of the brown area, followed by the placing of Type 1 sub-base and a macadam overlay to form a heavy duty interim access.
We were advised that Cala Homes are fully aware that, when these interim works are completed, they will have to cease work on the site until the Cranleigh Sewage Treatment Works have been upgraded and are “fit for purpose” – that is, they have the capacity to efficiently process not only the sewage from existing properties but also that from new dwellings.
Both the Cranleigh Civic Society and Summerlands Estate Residents Association will continue to liaise with Cala Homes through the Residents Liaison Group and monitor development on the Amlets Park estate.
